Understand and quantify your major risks and know what you have to prove to get your product to market.
General approach
- Quantify the level of risk in a technology
 - Ensure that all milestones are focused on reducing risk
 - Identify milestones that are most important to reducing risk
 - Communicate the reduction in risk relative to time and cost involved

Steps taken:

Step 1: Identify major technical risk areas
- Identify and group critical technical risks or failure modes by product component

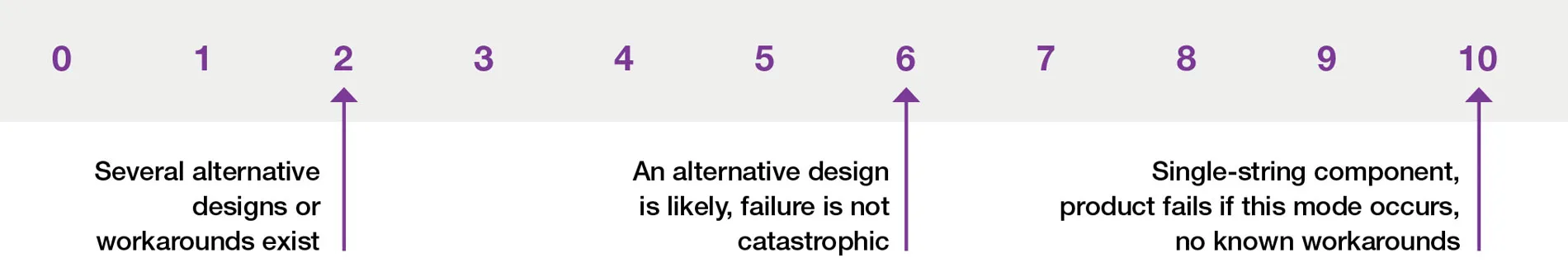

 - Groups of components also can have additional risks or failure modes

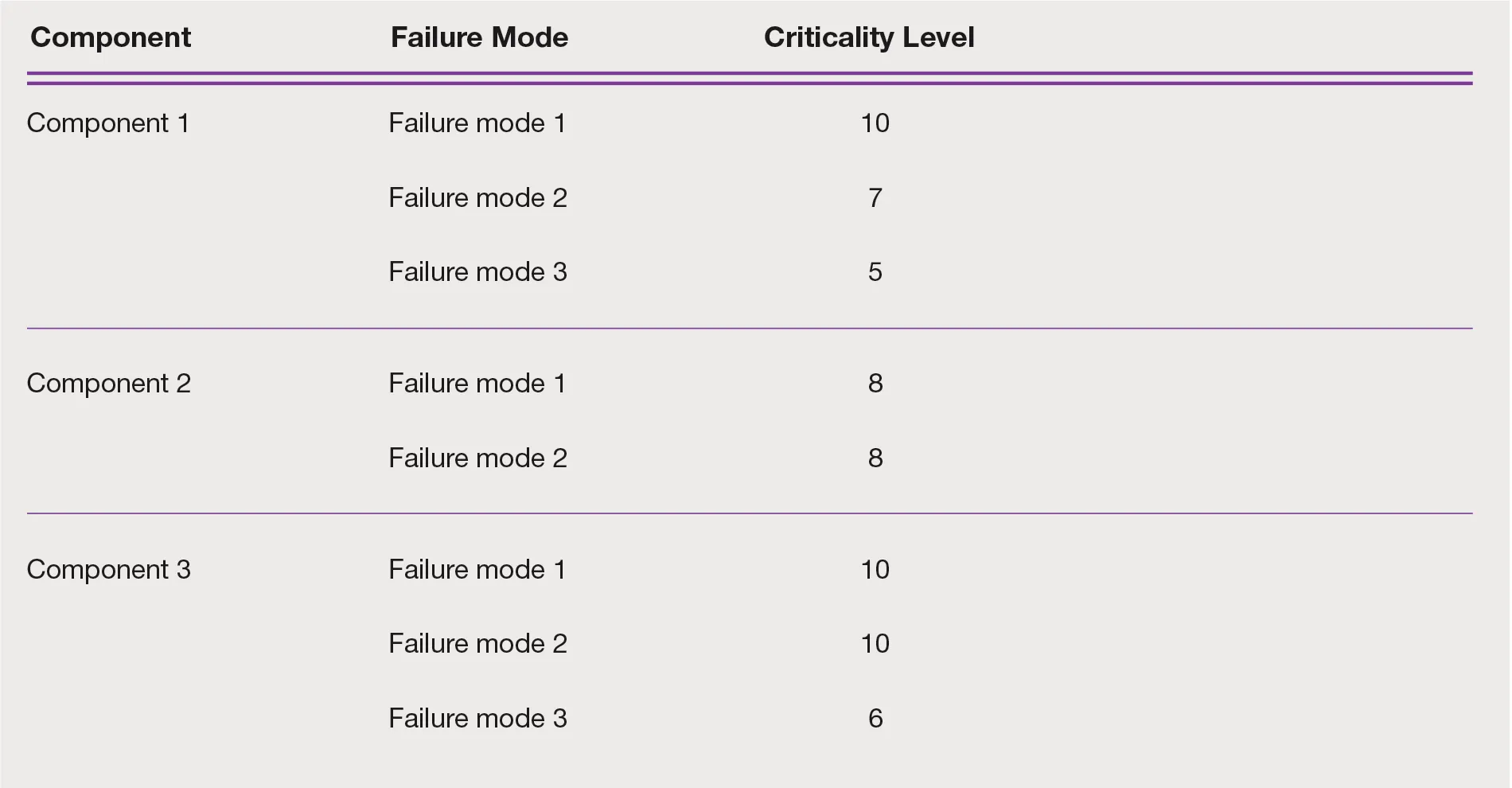

- Assign each risk a weighting factor on a scale of zero to 10, based on criticality and importance relative to component performance
 - The weighting factors represent the importance of when something goes wrong


- Each component or component group also can be weighted relative to its importance to product success
 - Each failure mode represents a different way that a component can fail

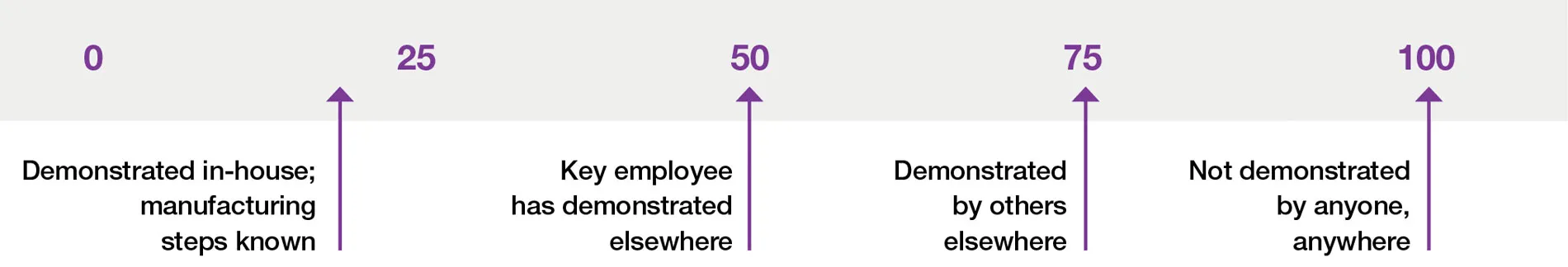

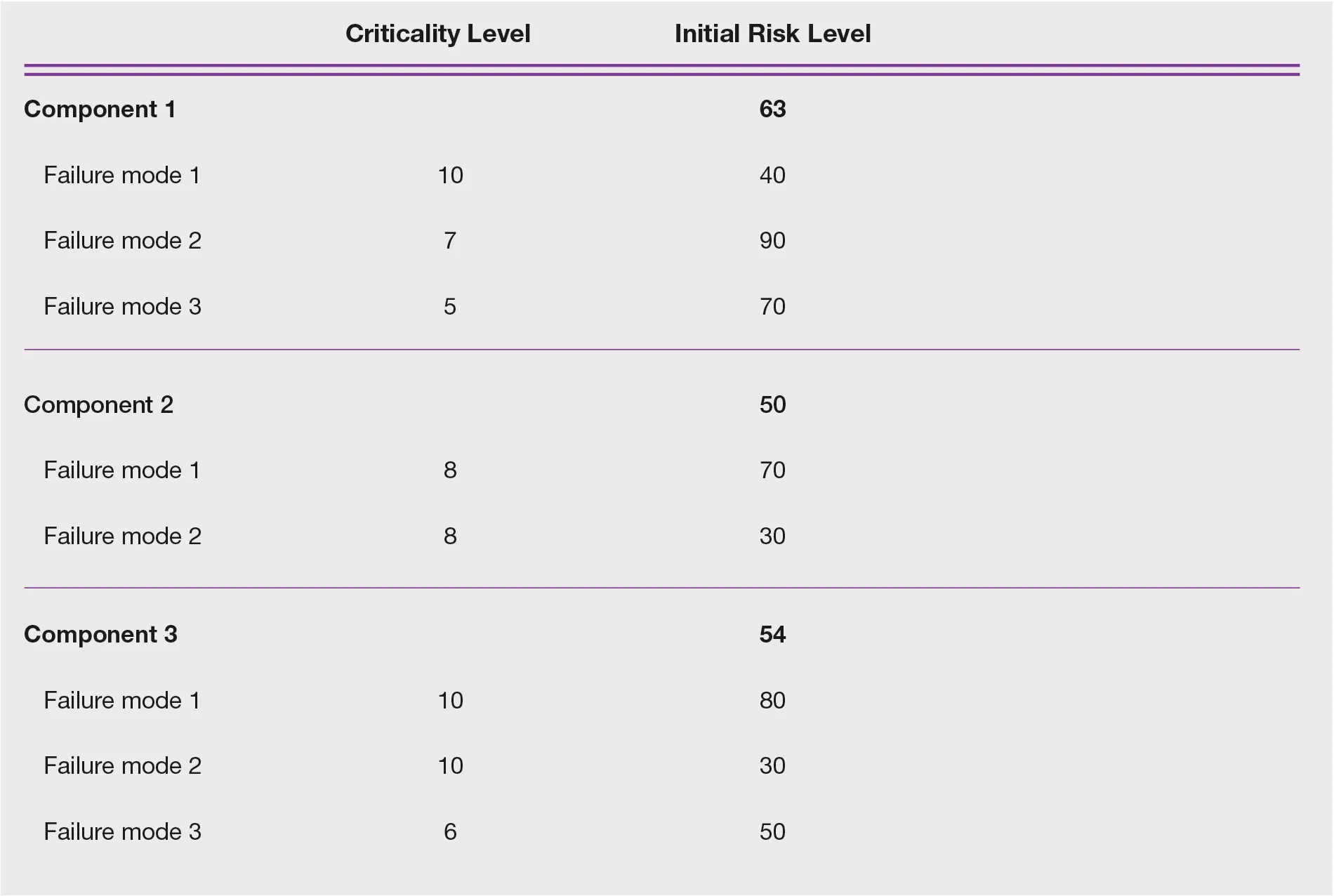

Step 2: Assign an initial absolute level to each risk
- Assign an initial and absolute risk level, on a scale from zero to 100, based on your level of confidence in preventing the failure mode at a manufacturing level


- The total initial level of risk of a component is the weighted average of the risk levels of the failure modes

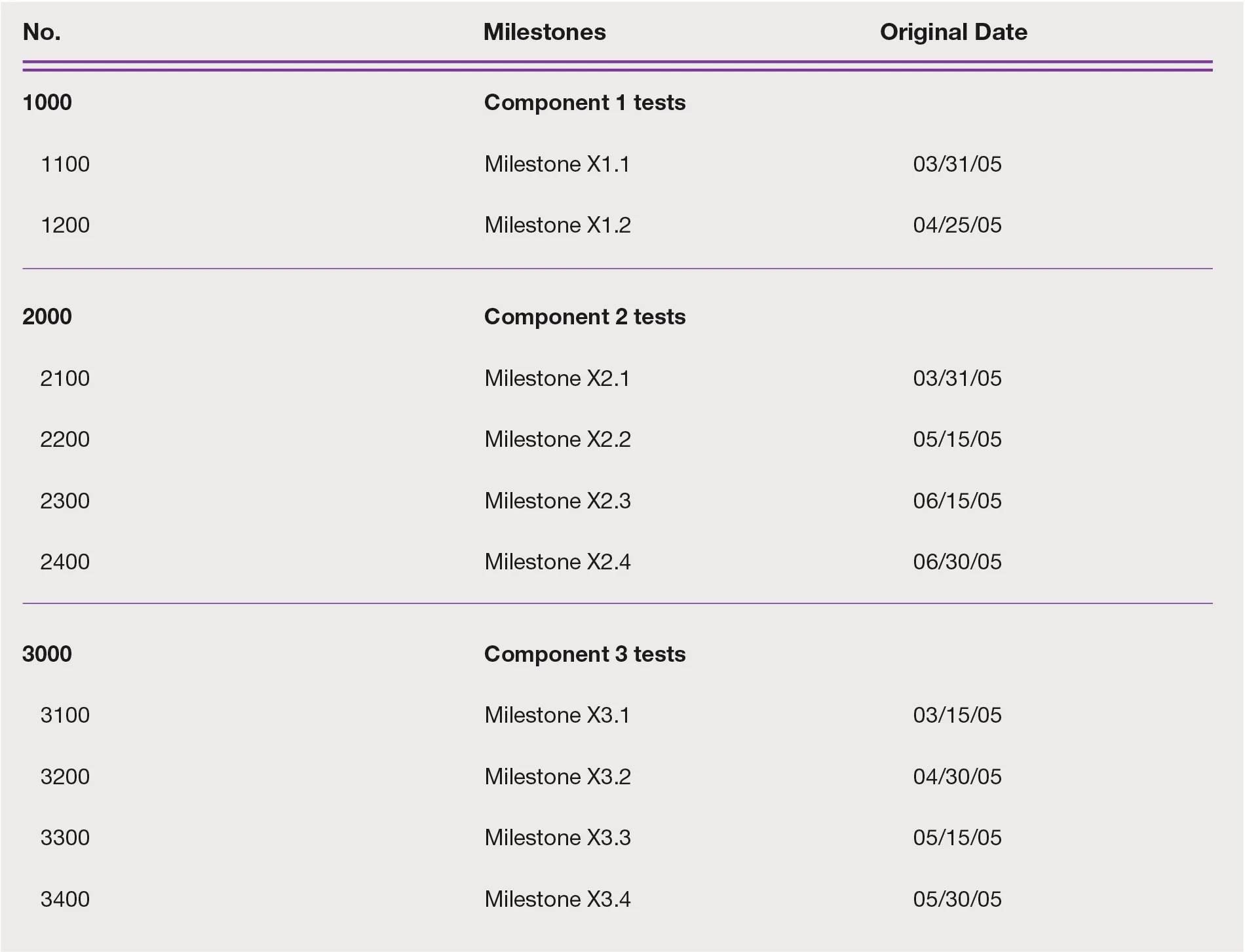

Step 3: Lay out a milestone schedule
- List major project milestones (from Gantt chart)
 - Each milestone is expected to reduce risk in one or more categories


Step 4: Assign a level of risk reduction associated with successful completion of milestone

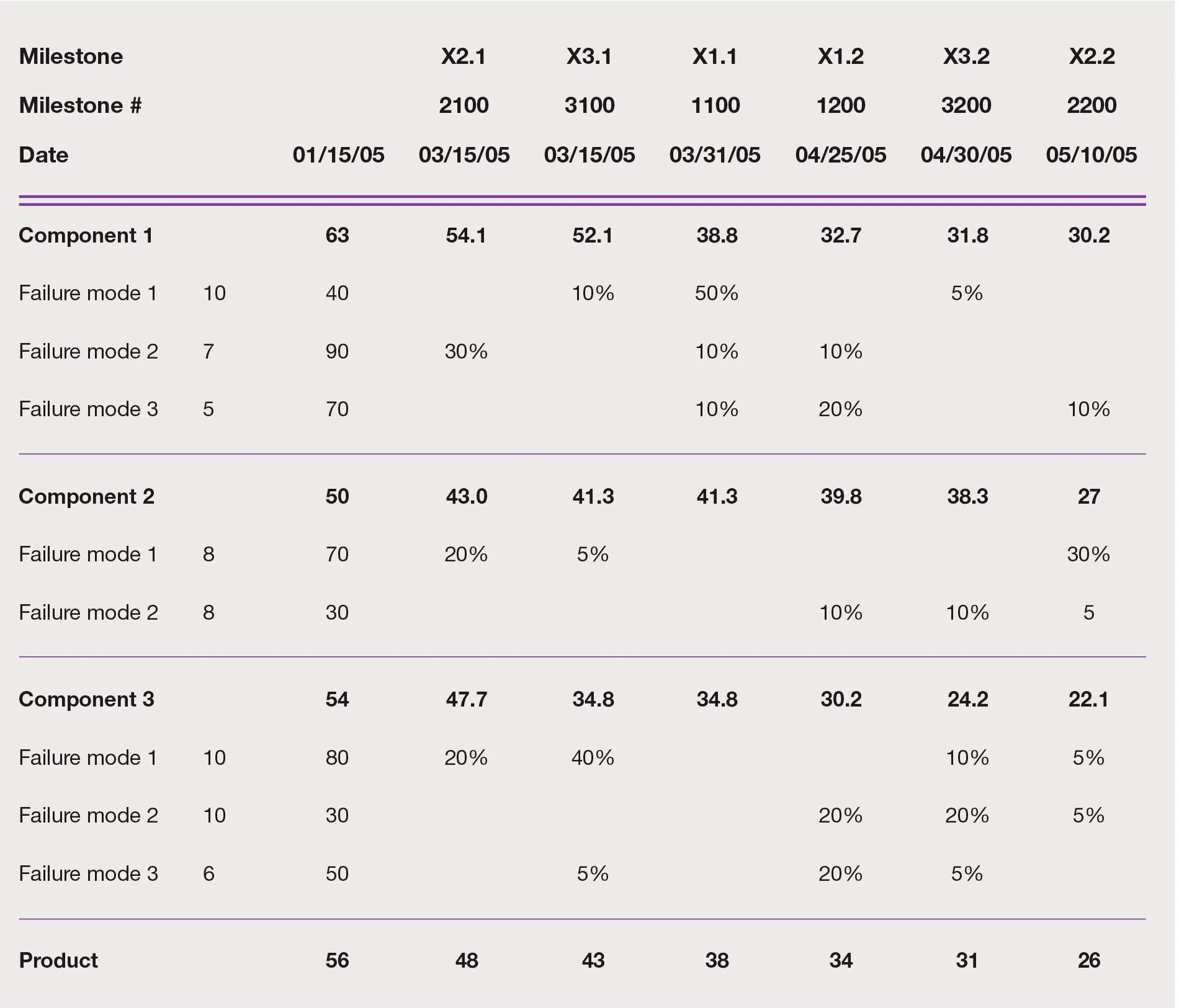

- Lay out risks and milestones in a matrix
 - Each milestone reduces the risk of a particular failure mode by some percentage
 - When a milestone is achieved, the absolute risk associated with a component falls resulting in a reduction in the overall product risk (the average of all component risks)

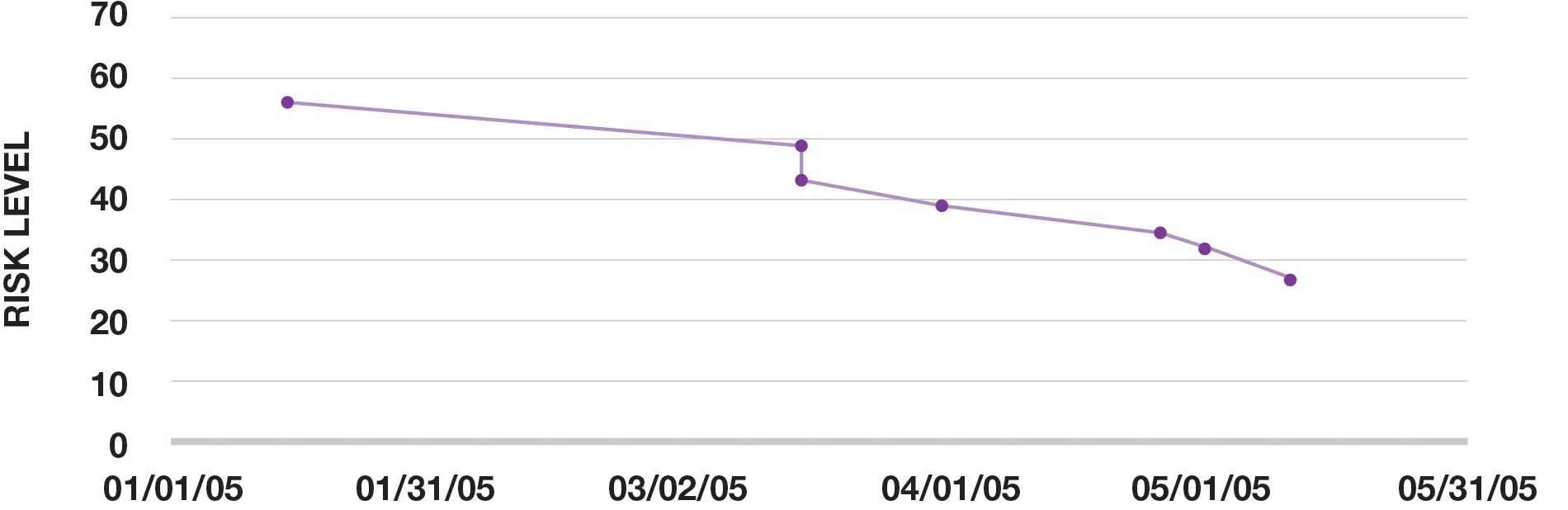

Step 5: Track risk reduction relative to time and expenditures to show progress
- For any component (and for product risk), risk reduction can be plotted relative to time and milestones
 - Expenditures also may be plotted relative to time on the same charts

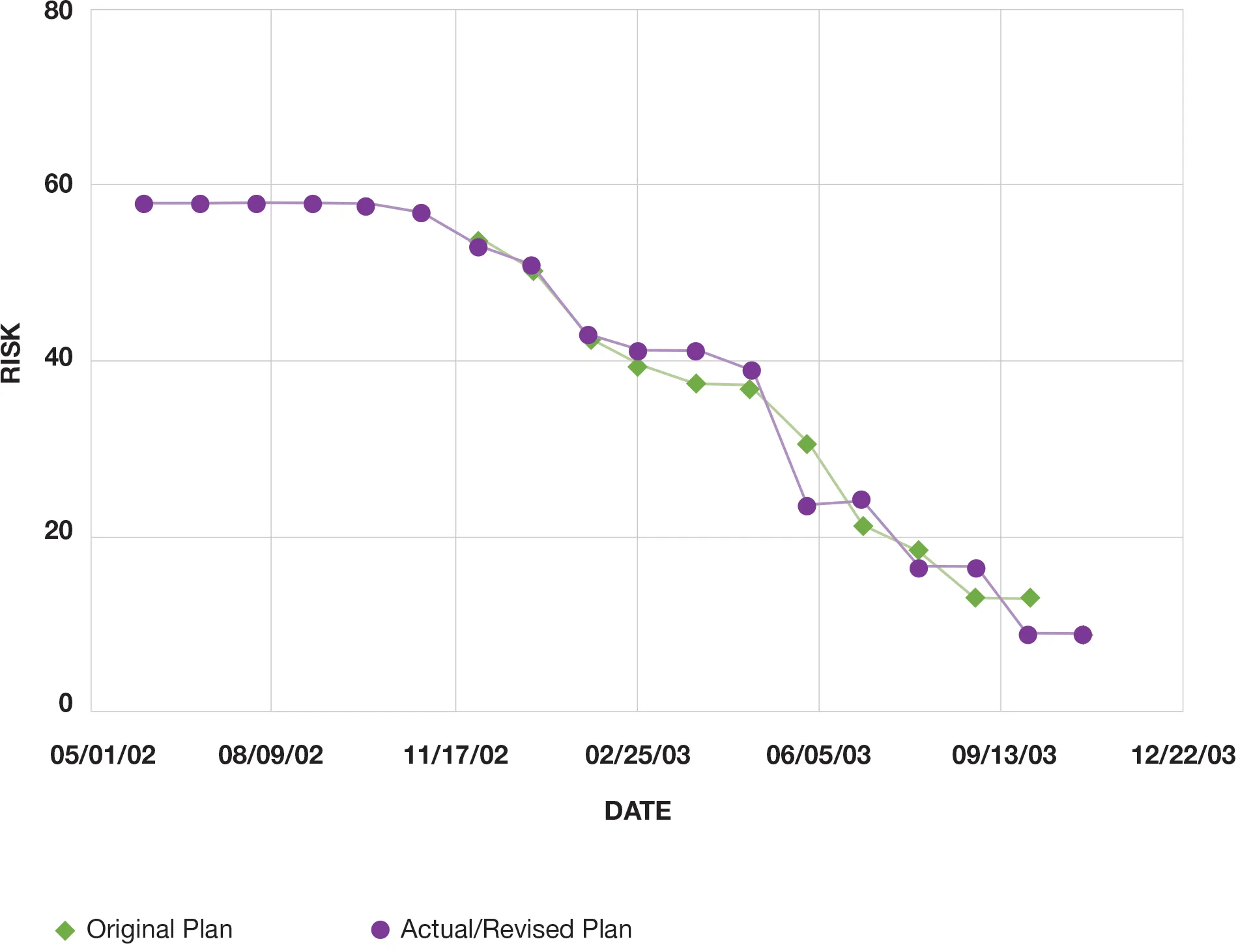

Single component risk reduction

Product risk reduction

Risk matrix example
Product risk reduction
